Skip to content
Chi Mino Ozhitoowin

Construction progress

Building the Waasigan line, month by month

Construction on the Waasigan Transmission Line, tracked from Valard's monthly updates and the project newsletter — from first clearing to the first tower to stringing the line. New to transmission terms? There's a plain-language guide to the words at the bottom of the page. Latest: Spring 2026.

  1. Spring 2026

    Construction resumes across both phases after a spring pause

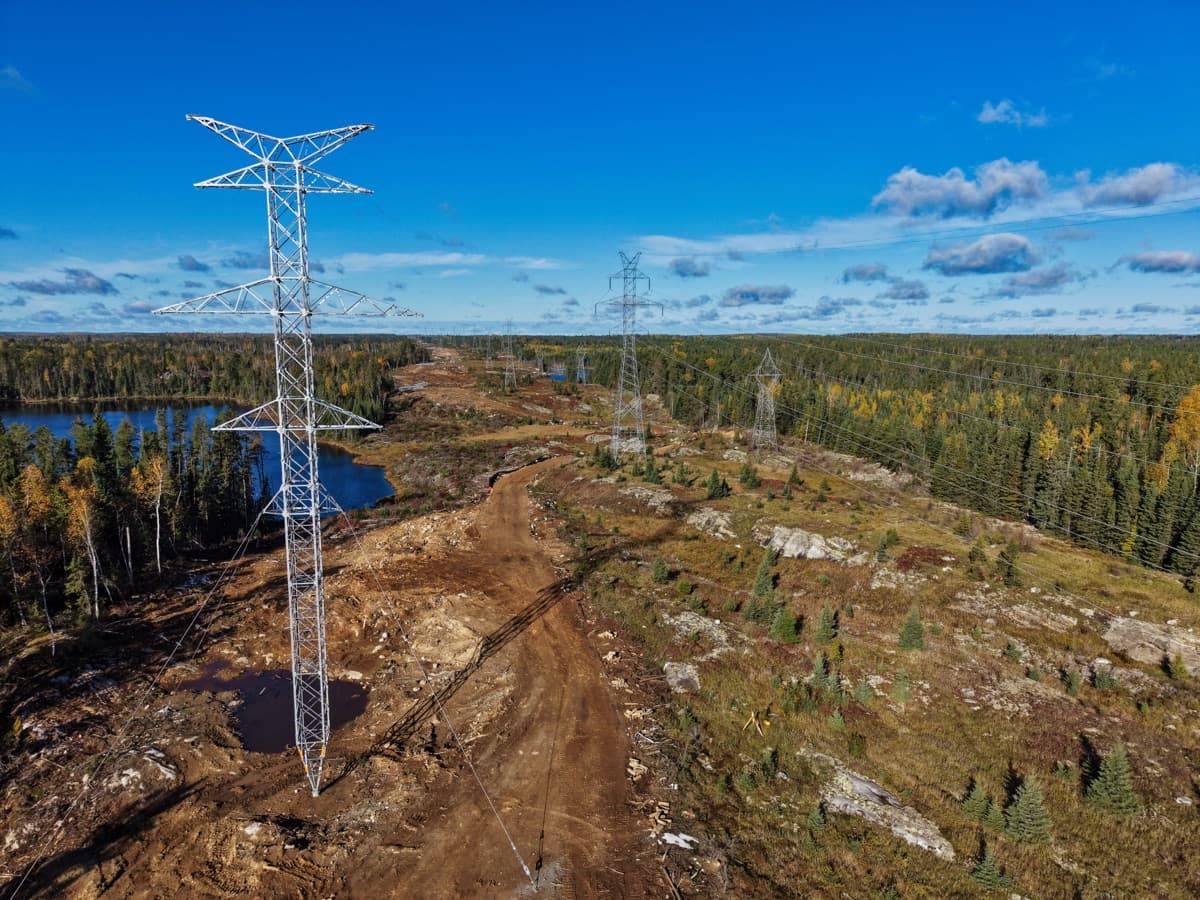

    Aerial view of a completed lattice transmission tower beside the cleared right-of-way, with lakes and boreal forest beyond.

    During a tower installation in March, an anchor system failure caused the structure to come down — no one was injured. Tower installation was paused while a third-party investigation ran; it found the precast concrete anchors were not installed to design specification, not a flaw in the engineering design or material. After the April–early May slowdown, the Ignace camp reopened May 11 and crews returned to the field on both phases.

    • No injuries in the March anchor failure; affected anchor types inspected and being reinstalled with added process mitigation, increased supervision, and quality-control checks
    • Ignace camp reopened May 11 — partner communities notified as work restarted across both phases
    • Phase 1 by May 31: foundations 96%, anchors 93%, assembly 78%, erection 56%, stringing 40%
    • Phase 2 construction plan shared: helicopters to support foundations and tower erection in work fronts six through eight this summer and fall, and ~9 km of winter road converting to all-season access

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    100%
    Access
    100%
    Foundations
    96%
    Anchors
    93%
    Assembly
    78%
    Erection
    56%
    Stringing
    40%

    Phase 2 · Atikokan → Dryden

    Clearing
    99%
    Access
    75%
    Foundations
    13%
    Anchors
    10%
    Read the Spring 2026 newsletter
  2. February 2026

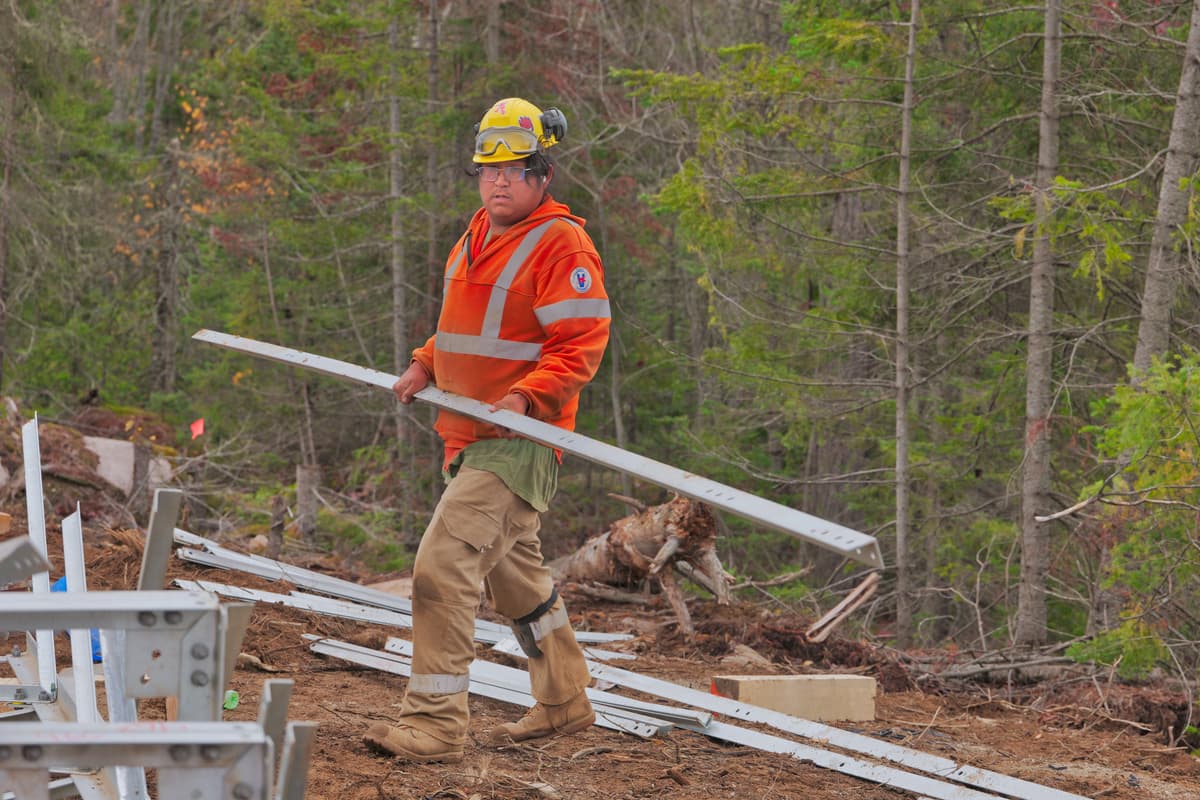

    Phase 1 fully cleared as tower erection climbs to 42%

    A worker carries steel lattice tower members along the cleared right-of-way.

    Phase 1 clearing of the right-of-way — the corridor of land the line runs through — and access reached 100%, while foundations, tower assembly, erection, and stringing all advanced toward Thunder Bay. Phase 2 clearing hit 90%, on track to finish before fire season.

    • Phase 1 clearing and access both reached 100% complete
    • Foundations advanced to 76% and anchors to 71%; assembly 64%, erection 42%, stringing 30%
    • Phase 2 clearing reached 90% and access 63% — clearing, hand falling, and burning to finish before March 31
    • Ice bridges and watercourse crossings installed and maintained through month-end

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    100%
    Access
    100%
    Foundations
    76%
    Anchors
    71%
    Assembly
    64%
    Erection
    42%
    Stringing
    30%

    Phase 2 · Atikokan → Dryden

    Clearing
    90%
    Access
    63%
    Read the full Valard update
  3. January 2026

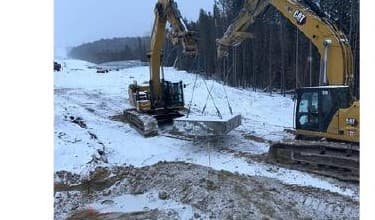

    Assembly hits 291 structures as the line powers into 2026

    Two excavators install a transmission foundation in the snow-covered right-of-way.

    Crews kept the line moving through deep winter — clearing and developing access across both phases while advancing foundations, assembly, and stringing in Phase 1. Phase 2 clearing reached 74%, with foundation and anchor work set to begin mid-January.

    • 291 structures assembled and 328 foundations completed (rock, micropile, helical, and concrete — different foundation types for different ground conditions)
    • 37 km of conductor pulled and 25 km of fiber installed and tied in
    • Phase 2: 499 structures cleared and access developed to 493 structures
    • Burn program continuing until March 31, 2026

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    99%
    Access
    98%
    Foundations
    65%
    Anchors
    62%
    Assembly
    57%
    Erection
    32%
    Stringing
    16%

    Phase 2 · Atikokan → Dryden

    Clearing
    74%
    Access
    49%
    Read the full Valard update
  4. December 2025

    First conductor pull strung — stringing officially underway

    A helicopter strings conductor wire at a transmission tower.

    Valard's Wireworks team completed the first stringing pull on the line on December 5 — pulling the first stretch of conductor, the wire that carries the power, from tower to tower — kicking off the Phase 1 stringing program. Crews also prepped winter access roads in Phase 2 ahead of foundation work in the new year.

    • First Stringing Pull completed December 5 — a key Phase 1 milestone, building on October's first tower raising
    • Phase 1: foundations 61%, anchors 56%, assembly 51%, erection 25%, stringing started at 7%
    • Phase 2 underway: clearing 44% and access 25% complete
    • Indigenous workforce now 38% of the total construction crew

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    97%
    Access
    92%
    Foundations
    61%
    Anchors
    56%
    Assembly
    51%
    Erection
    25%
    Stringing
    7%

    Phase 2 · Atikokan → Dryden

    Clearing
    44%
    Access
    25%
    Read the full Valard update
  5. November 2025

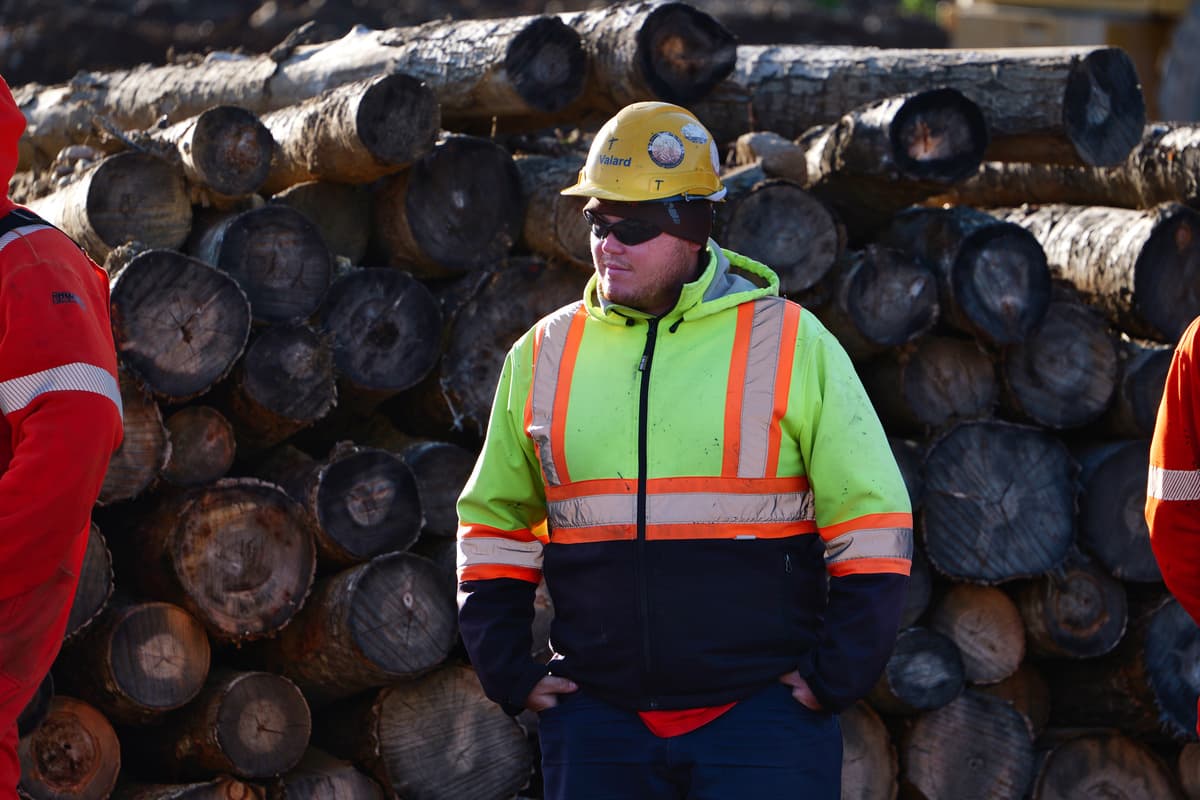

    Phase 1 clearing hits 97% as crews gear up for stringing

    A crew member stands by stacked salvaged timber from right-of-way clearing.

    Phase 1 is well advanced, with clearing at 97% and access at 87%. Crews geared up for conductor stringing — using helicopters and implosive splicing, which joins wire ends with a small controlled charge — ahead of the first pull, while Phase 2 clearing and access ramped up for the winter.

    • Phase 1 preparing for stringing — helicopters and implosive splicing — ahead of the first pull
    • Phase 1: clearing 97%, access 87%, foundations 59%, anchors 54%, assembly 46%, erection 15%
    • Phase 2 underway with clearing at 27% and access at 12%
    • Indigenous apprenticeships progressing — one active, four more in the pipeline

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    97%
    Access
    87%
    Foundations
    59%
    Anchors
    54%
    Assembly
    46%
    Erection
    15%

    Phase 2 · Atikokan → Dryden

    Clearing
    27%
    Access
    12%
    Read the full Valard update
  6. October 2025

    The first transmission tower rises on the Waasigan line

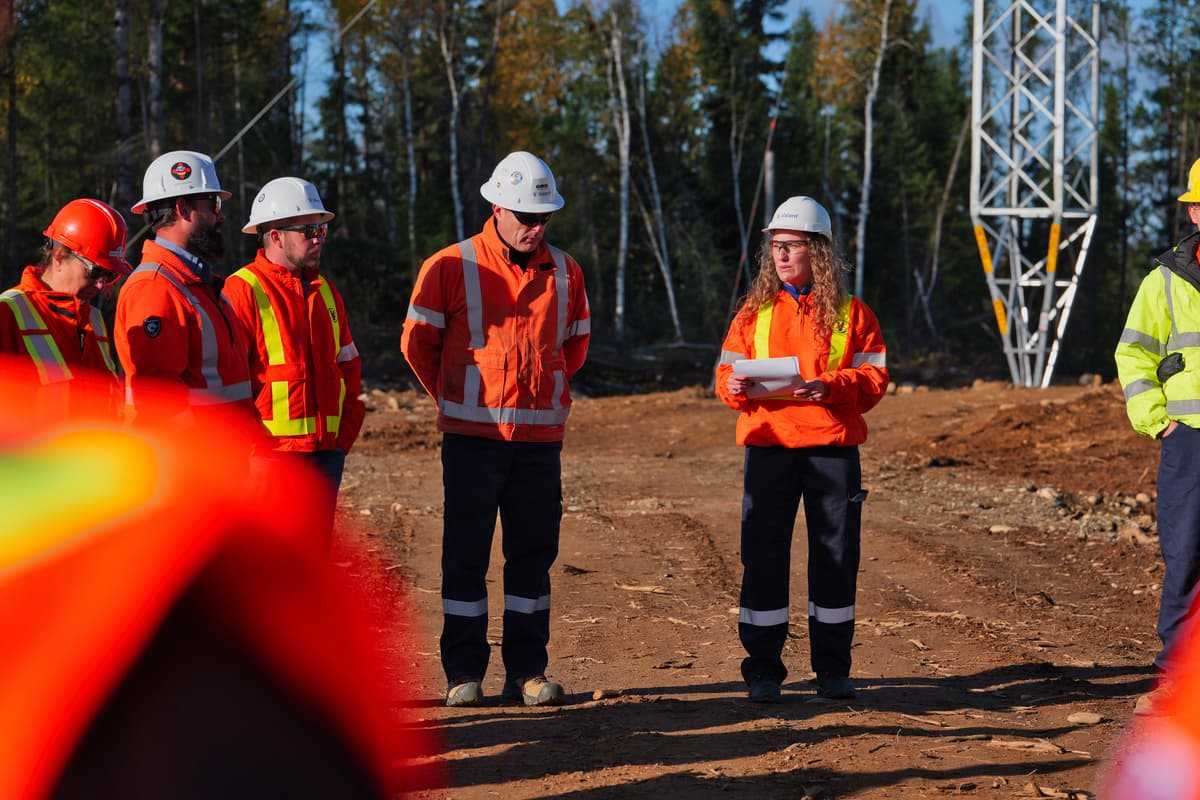

    Crews and community monitors gather at the base of a transmission tower on the right-of-way.

    The project's first transmission tower was erected on October 6, honoured by Indigenous communities and environmental monitors representing seven First Nations. Phase 1 clearing reached 80% as Phase 2 began ramping up.

    • First tower erected October 6 at structures A30L/A31L-336, honoured by the seven First Nations
    • Phase 1: clearing 80%, access 56%, foundations 50%, assembly 35%
    • 13 loads of salvaged timber delivered to participating communities
    • Phase 2 ramping up: clearing 5%, access 3%

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    80%
    Access
    56%
    Foundations
    50%
    Assembly
    35%

    Phase 2 · Atikokan → Dryden

    Clearing
    5%
    Access
    3%
    Read the full Valard update
  7. September 2025

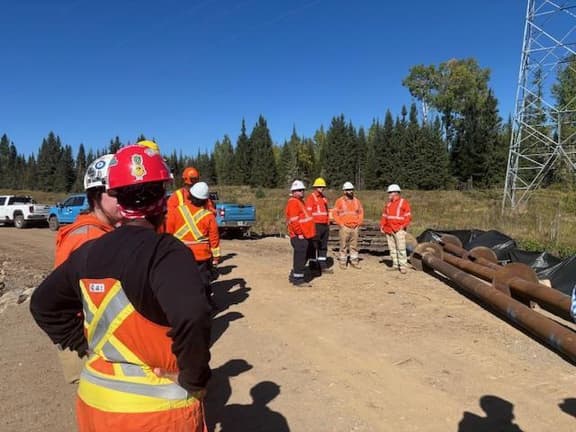

    Assembly ramps up ahead of the first tower erection

    An assembly crew gathers with materials and a transmission tower on the right-of-way.

    Crews focused on right-of-way clearing and tower foundations while the Ignace Camp was completed and occupied, setting up the first Phase 1 tower erection on October 6. Most of the assembly crews are Indigenous.

    • Phase 1 clearing reached 72% and access 55%; foundations 39%, assembly 21%
    • Ignace Camp finished — crews began staying on-site in mid-September
    • First Phase 1 tower erection scheduled for October 6
    • 70% of the project's assembly crews are Indigenous, including four entirely Indigenous crews

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    72%
    Access
    55%
    Foundations
    39%
    Assembly
    21%
    Read the full Valard update
  8. August 2025

    Tower assembly begins as foundations cross 29%

    Workers walk through the Ignace construction camp.

    The Tower Assembly Program launched with eight crews, and tower foundations advanced to 29%. Ignace Camp neared completion ahead of tower erection beginning in October.

    • Tower Assembly Program kicked off, with eight newly hired crews (many Indigenous employees)
    • Phase 1: clearing 71%, access 54%, foundations 29%, assembly 9%
    • Ignace Camp nearly complete — workers move on-site mid-September
    • Phase 1 tower erection scheduled to start in October

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    71%
    Access
    54%
    Foundations
    29%
    Assembly
    9%
    Read the full Valard update
  9. July 2025

    Phase 1 clearing reaches 71% across five work fronts

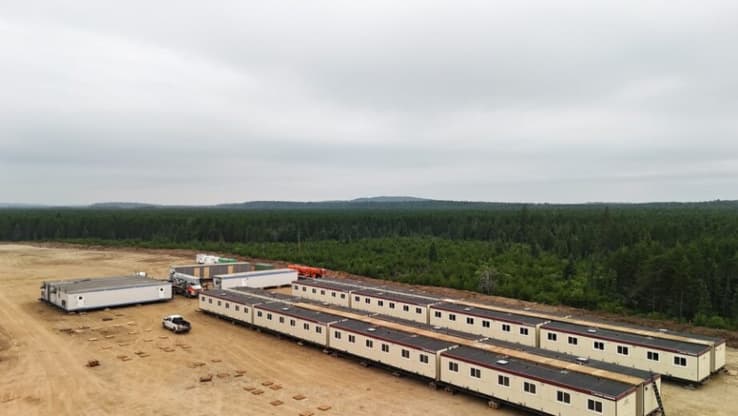

    Aerial view of the Ignace construction camp under construction.

    Valard advanced Phase 1 across multiple fronts, with clearing 71% complete and foundation and anchor installations underway in Work Fronts 3–5. In Phase 2, Ignace Laydown camp construction progressed toward an end-of-August occupancy target.

    • Phase 1 clearing reached 71% as of July 31
    • Access construction at 42% — crews installing geofabrics, corduroy, and mats (ground coverings that protect soil and wetlands) and building water crossings
    • Foundation and anchor installations underway in Work Fronts 3–5 (foundations 18%)
    • Phase 2 Ignace camp construction in progress; occupancy expected end of August

    Phase 1 · Thunder Bay → Atikokan

    Clearing
    71%
    Access
    42%
    Foundations
    18%
    Assembly
    3%
    Read the full Valard update

What the words mean

The updates above use the crews’ own words for the work. Here is what each stage means in plain language.

Right-of-way
The cleared corridor of land the transmission line runs through.
Clearing
Removing trees and brush from the right-of-way so crews can work safely.
Access
Building the roads, water crossings, and ground mats crews use to reach each tower site.
Foundations & anchors
The concrete and steel supports set into the ground that hold each tower in place.
Assembly
Bolting the steel tower sections together on the ground.
Erection
Standing the assembled tower upright — by crane, or by helicopter in remote sections.
Stringing & conductor
Pulling the conductor — the wire that carries the electricity — from tower to tower.
Implosive splicing
Joining two conductor ends with a small, precisely shaped charge that fuses them into one strong connection.
Work front
One section of the route where a crew is working. Several work fronts run at the same time.
Transformer station (TS)
Where the line connects to the wider power grid — Lakehead (Shuniah), Mackenzie (Atikokan), and Dryden.

For the story behind the build — the people, the communities, and the milestones — read the project newsletter.

Read the newsletter
